27/05/2007 - Start
27/05/2007
- RV-7 Empennage kit ordered
Faxed
the orders to Van's today. I have ordered the empennage kit
without the lights option, as well as the two practice kits, the
Rvator subscription, another set of preview plans for Bob (which
will help with discussions over the phone), and the standard
aircraft book.
12/06/2007 - RV-7 Empennage kit
has arrived
The
two boxes arrived at 11:00am, and I couldn't wait to open it up !
shame I had to go to back to work really :-(. In the evening
the inventory process started with all the little brown bags
holding rivets and bolts. They have been put away in their
own storage bins and labelled, much to the amusement of friends
who have said I have never been that organised.
14/06/2007 - RV-7 Empennage kit inventory completed
There

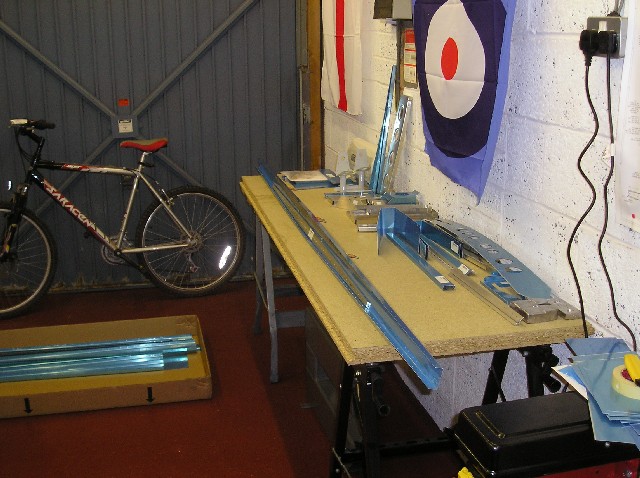

are a lot of aluminium parts all over the garage, but everything
is correct and accounted for. Time to build some shelves for
parts and skins I think and put them well out of harms way ! There
are a few practice sheets as well which comes in handy, and I

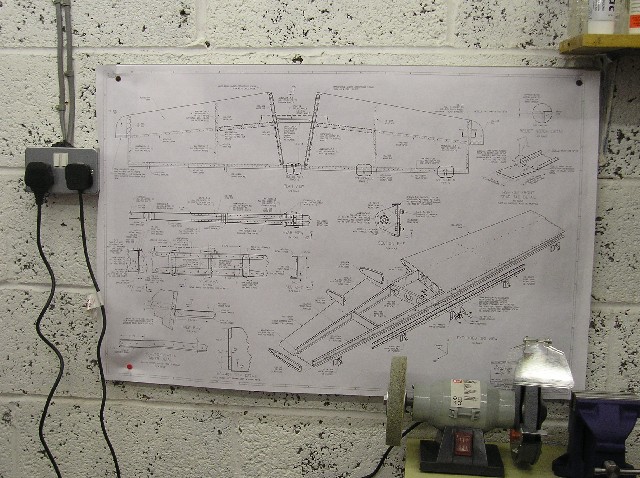

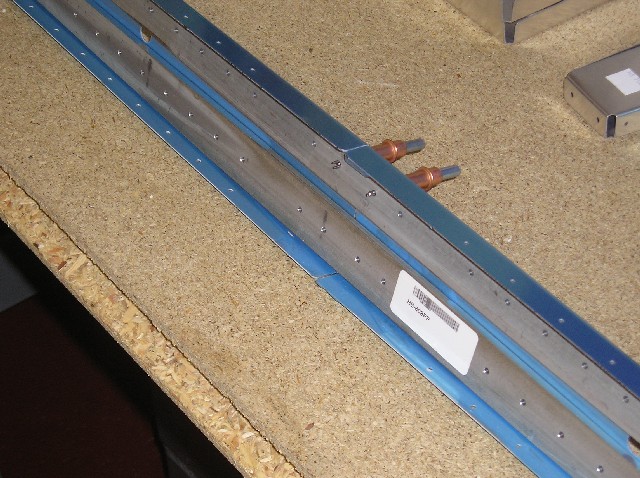

could not resist cleco'ing the stabiliser rear spar together, just
to try a few tools out.
Not
ready to start building yet though, I still have benching,
shelving, tool configuration and practise kits to build ....oh and
the small matter of permission to build, the forms have not
arrived back from the PFA yet.
17/06/2007 - RV-7 empennage kit all tucked away out of harms way
20/06/2007
- My build number has been granted - PFA 323-14691
Its
finally here, the aircraft has a serial number. It comes
with plenty of reading. Things always arrive with plenty of
reading. Number of hours doing aircraft assembly so far 0,
number of hours getting set up, lost count. I am reminded of
the rude version of the 5 P's, ok the rude version is 6 P's and I
stay up till late reading through the documentation.
21/06/2007
- Empennage Paused
Work
on the empennage is now on hold until the following have been
completed
02/08/2007 - I am cleared to get started on the
RV itself ...wahoo.
Click
on the dates below to jump to the corresponding page.
Horizontal Stabiliser
05/08/2007 - Horizontal Stabiliser -
Rear Spar fabricated & Started on front spar
[7.0hrs]
06/08/2007 - Horizontal Stabiliser -
More work on the front spar
[1.0hrs]
08/08/2007 - Horizontal Stabiliser -
HS404 cutting & preparing
[1.0hrs]
11/08/2007 - Horizontal Stabiliser -
Left hand HS assembly
[7.0hrs]
12/08/2007 - Horizontal Stabiliser -
Right hand HS assembly
[5.0hrs]
14/08/2007 - Horizontal Stabiliser -
Deburring; Dimpling & Prepping
[8.0hrs]
19/08/2007 -
Horizontal Stabiliser -
Sent for priming
[0.0hrs]
02/09/2007 -
Horizontal Stabiliser -
Elevator bearing on rear spar
[3.0hrs]
09/09/2007 -
Horizontal Stabiliser -
Priming done, rear spar starts
[3.0hrs]
10/09/2007 -
Horizontal Stabiliser -
Rear spar nearly done
[2.5hrs]
12/09/2007 -
Horizontal Stabiliser -
Elevator hinges & bolts
[1.0hrs]
15/09/2007 -
Horizontal Stabiliser -
Riveting the front spar
[3.0hrs]
16/09/2007 -
Horizontal Stabiliser -
Started left hand skin rivets
[3.5hrs]
19/09/2007 -
Horizontal Stabiliser -
Finished left hand skin rivets
[2.0hrs]
26/09/2007 -
Horizontal Stabiliser -
Started & Completed right hand skin
[5.0hrs]
Horizontal Stabiliser Ready For Inspection
08/10/07 - Step 10
Horizontal Stabiliser Inspected
& Passed
12/10/2007 -
Horizontal Stabiliser -
Installed & riveted rear spar
[1.5hrs]
Vertical Stabiliser
16/08/2007 - Vertical Stabiliser -
Sub structure assembly
[5.0hrs]
17/08/2007 - Vertical
Stabiliser -
Skinning; Deburring; Dimpling &
Prepping
[5.0hrs]
19/08/2007 - Vertical Stabiliser -
Sent for priming
[0.0hrs]
13/10/2007 -
Vertical Stabiliser -
Riveting the rear spar & skeleton
[2.5hrs]
20/10/2007 -
Vertical Stabiliser -
Riveting the skin to the skeleton
[3.0hrs]
Vertical Stabiliser Ready For Inspection
18/11/07 - Step 8
Vertical Stabiliser Inspected
& Passed
25/11/2007 -
Vertical Stabiliser -
Riveting the rear spar to the fin
[1.5hrs]
Rudder
17/08/2007 - Rudder -
Creating right hand side stiffeners
[2.0hrs]
18/08/2007 - Rudder -
Creating left hand side stiffeners
[4.0hrs]
19/08/2007 - Rudder -
Drilling & dimpling stiffeners.
Rudder horn.
[8.0hrs]
26/08/2007 - Rudder -
More work on rudder skeleton
[2.5hrs]
20/09/2007 -
Rudder -
Stiffeners riveted to skins &
assemble
[3.0hrs]
22/09/2007 -
Rudder -
Drilling, deburring, dimpling,
priming
[4.0hrs]
11/11/2007 -
Rudder -
Started to rivet skeleton
[1.0hrs]
13/11/2007 -
Rudder -
Finished rivet main part of
skeleton
[3.0hrs]
Rudder Ready For Inspection
18/11/07 - Step 11
Rudder Inspected & Passed
18/11/2007 -
Rudder -
Started to rivet on the skins
[2.0hrs]
19/11/2007 -
Rudder -
Finished the spar, ribs and horn
rivets
[1.0hrs]
25/11/2007 -
Rudder -
Gluing the trailing edge
[3.0hrs]
28/11/2007 -
Rudder -
Cleaning up the trailing edge
[1.0hrs]
01/12/2007 -
Rudder -
Riveting the trailing edge
[3.0hrs]
09/12/2007 -
Rudder -
Rolling & Riveting the leading edge
[2.0hrs]
12/12/2007 -
Rudder -
Bearings and attached rudder to fin
[2.0hrs]
Elevators
26/08/2007 - Elevators -
Right hand elevator stiffeners
[2.5hrs]
27/08/2007 - Elevators -
Left hand elevator stiffeners & RH
skeleton
[5.5hrs]
29/08/2007 -
Elevators -
Match drilled Left hand elevator stiffeners
[1.5hrs]
31/08/2007 -
Elevators -
Left hand elevator deburring,
dimpling
[2.0hrs]
01/09/2007 -
Elevators -
Trim reinforcement plate &
Counterweights
[3.0hrs]
02/09/2007 -
Elevators -
Left elevator skeleton &
counterweight
[1.5hrs]
07/09/2007 -
Elevators -
Right elevator counterweight
[1.5hrs]
29/09/2007 -
Elevators -
Right elevator stiffeners riveted
to skin
[2.0hrs]
01/10/2007 -
Elevators -
Left elevator stiffeners & trim
inspection plate
[2.0hrs]
02/10/2007 -
Elevators -
Creating bending brake for
elevators
[1.0hrs]
14/10/2007 -
Elevators -
Bending trailing edge of elevators
& drilling
[7.0hrs]
29/11/2007 -
Elevators -
Riveting the right hand skeleton
[2.5hrs]
01/12/2007 -
Elevators -
Riveting the left hand skeleton
[1.5hrs]
09/12/2007 -
Elevators -
Folding the Trim tab ears
[2.0hrs]
12/12/2007 -
Elevators -
Folding the elevator tab ears
[2.0hrs]
29/12/2007 -
Elevators -
Various bits & pieces with
elevators & trim tab
[4.0hrs]
31/12/2007 -
Elevators -
Painting & Assembling the trim tab
[4.0hrs]
Elevators Ready For
Inspection
05/01/08 - Step 11
Rudder Inspected &
Failed !!!!
06/01/2008 -
Elevators -
Drilling out rivets !!!
[2.0hrs]
09/01/2008 -
Elevators -
Reassembly of elevator skeletons
[3.0hrs]
Elevators Ready For
Inspection
12/01/08 - Step 11
Rudder Inspected & Passed
13/01/2008 -
Elevators -
RH skin riveted to skeleton &
leading edge
[6.0hrs]
16/01/2008 -
Elevators -
LH skin riveted to skeleton &
leading edge
[5.0hrs]
19/01/2008 -
Elevators -
LH
leading edge
[5.0hrs]
Finishing
27/01/2008 -
Elevators -
Completion and trial fit
[5.0hrs]
